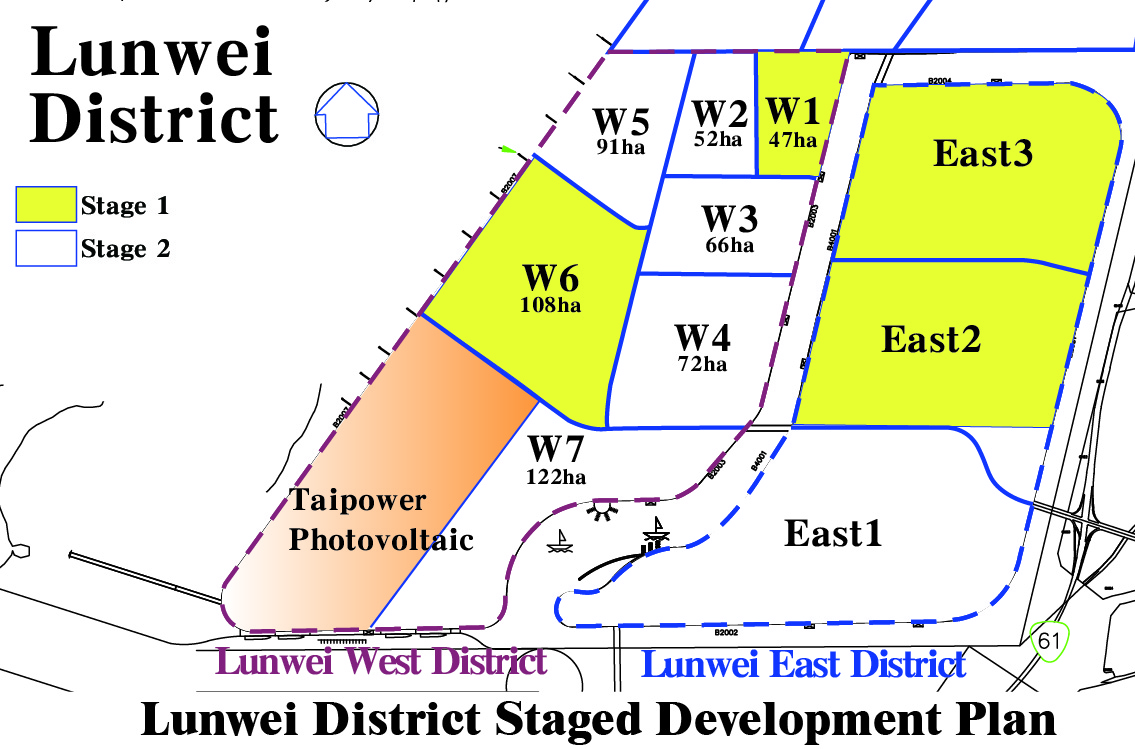

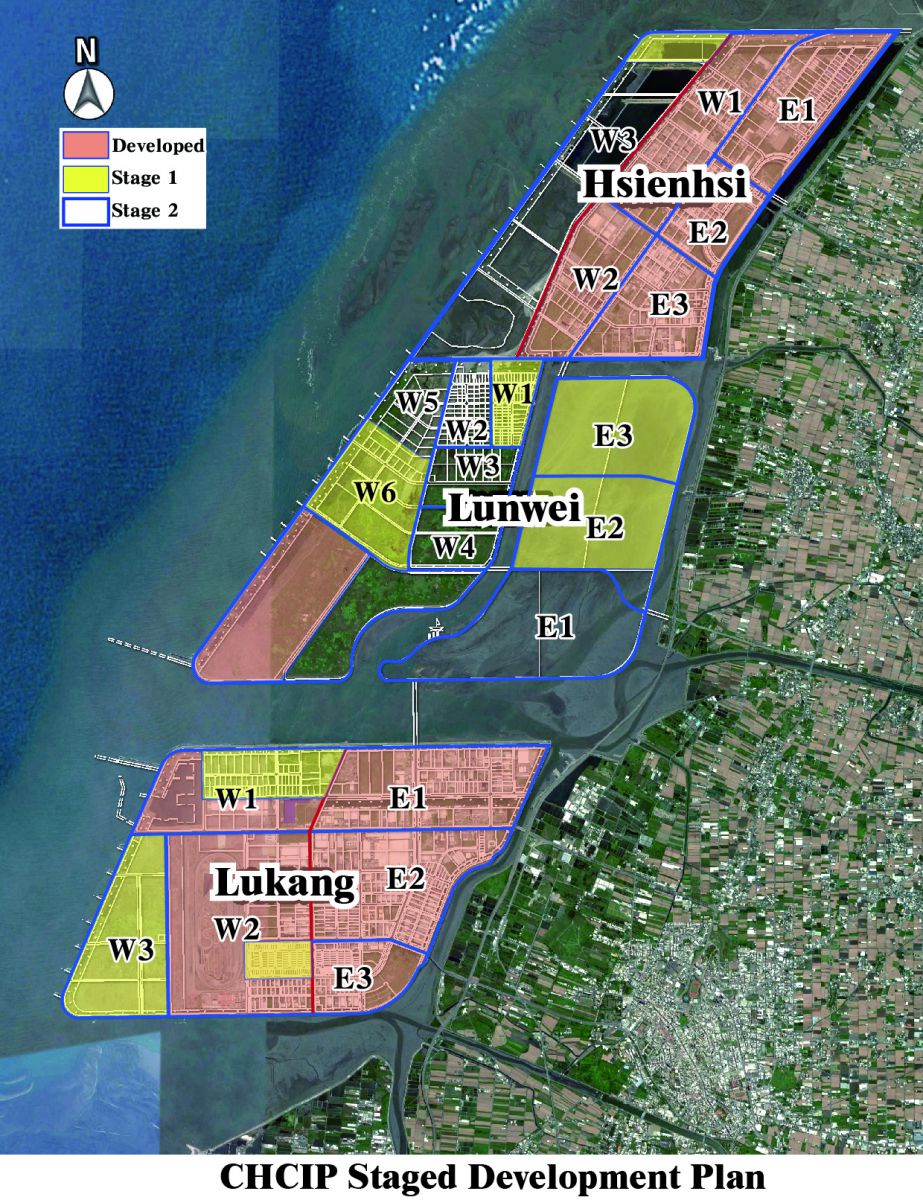

The development of the Lunwei District is to be made by phases. The reclamation project will be implemented first, and then the public facilities construction follows after the reclamation work is completed. By March 2017, the western area of the Lunwei District has completed the land preparation work, the areas of which are about 744 hectares, but the portion of public facilities has not yet been implemented. The land preparation work of eastern Lunwei has not been completed yet, and the land areas are about 600 hectares. The sequence of development phases of western Lunwei is illustrated as follows:

Development
Stage
Small District Area Description
2017 1 Western Lunwei
District #1, phase #1
47 hectares Has been announced for pre-registration in June 2016, the construction is slated to be kicked off in the second half of 2017.
2 Western Lunwei
Metal surface treatment area
75 hectares Slated to be announced in the second half of 2017
2019-2020 3 Western Lunwei
District #1, phase #2-5
264 hectares Reclamation completed, will partially develop according to the land lease/sale status
4 Western Hsienhsi
District #3, phase #2
64 hectares Reclamation not implemented yet, will develop with reclamation according to the specific requirements of enterprises

索賄或收賄申訴專線

  1. 本公司所有人員絕不接受任何廠商及其下包商給予賄賂或其他不正利益。
  2. 公司任何人員如有向廠商及其下包商索賄而違反前述聲明者,請具名逕向本公司檢舉、申訴,本公司必將嚴查;受理單位為稽核室,郵電地址:report@bes.com.tw 電話:(02)8787-7735、(02)8787-6522 ; 傳真:(02)8787-6250。
  3. 任何廠商及其下包商皆不得違反前述聲明,否則須自負一切法律責任。
  4. 非檢舉索收賄,請改撥 總機:(02)8787-6687
